Operations

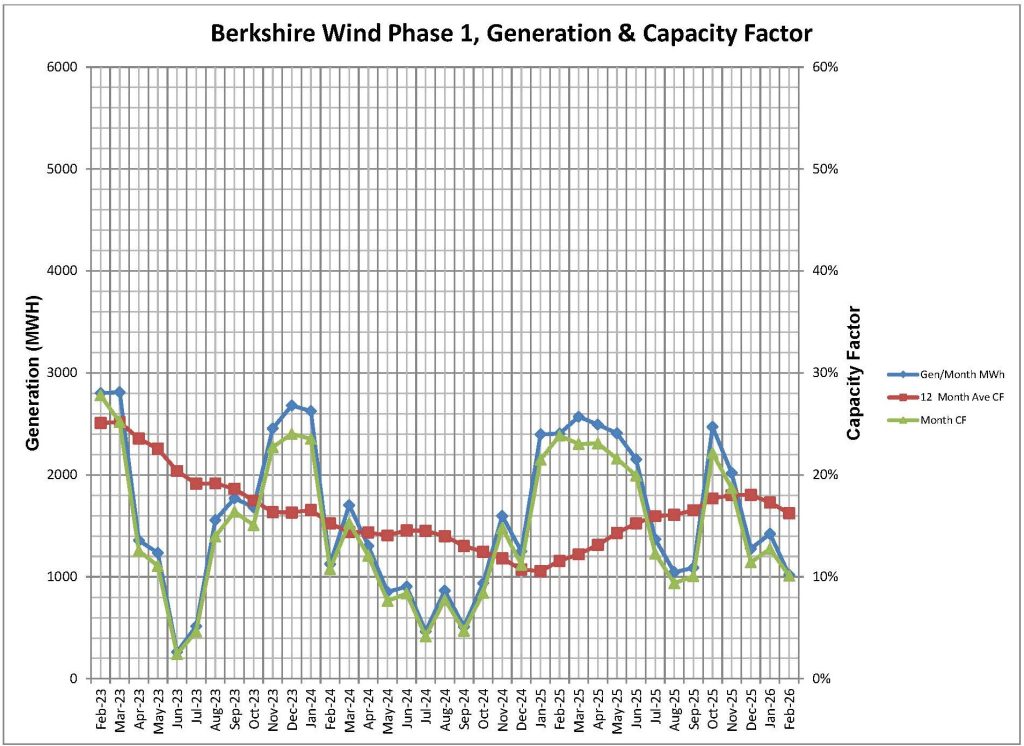

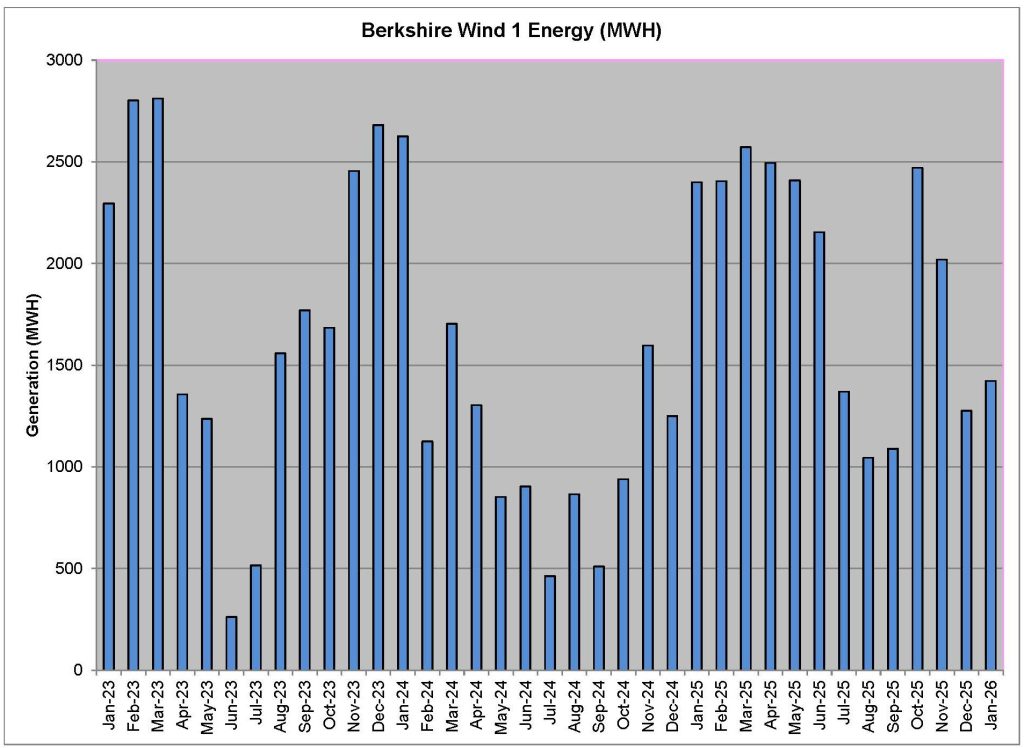

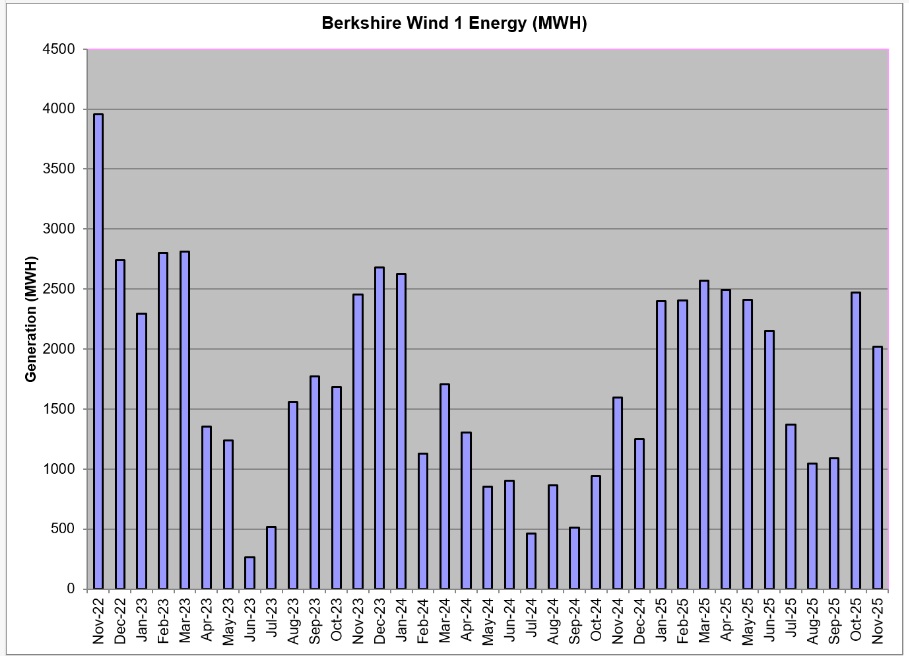

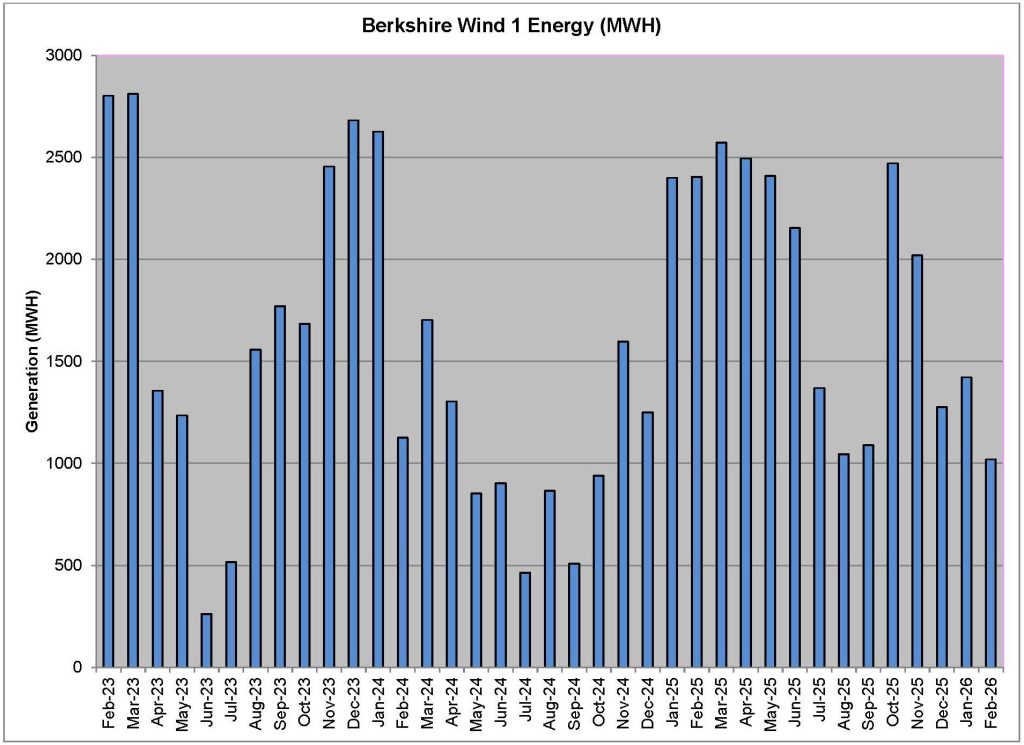

Berkshire Wind Phase I

The Unit Availability and Capacity Factors are as follows:

September 2026

Year-to-Date

Availability Factor (AF)

           69.47%

             36.86%

Capacity Factor (CF)

            14.11%

               9.51%

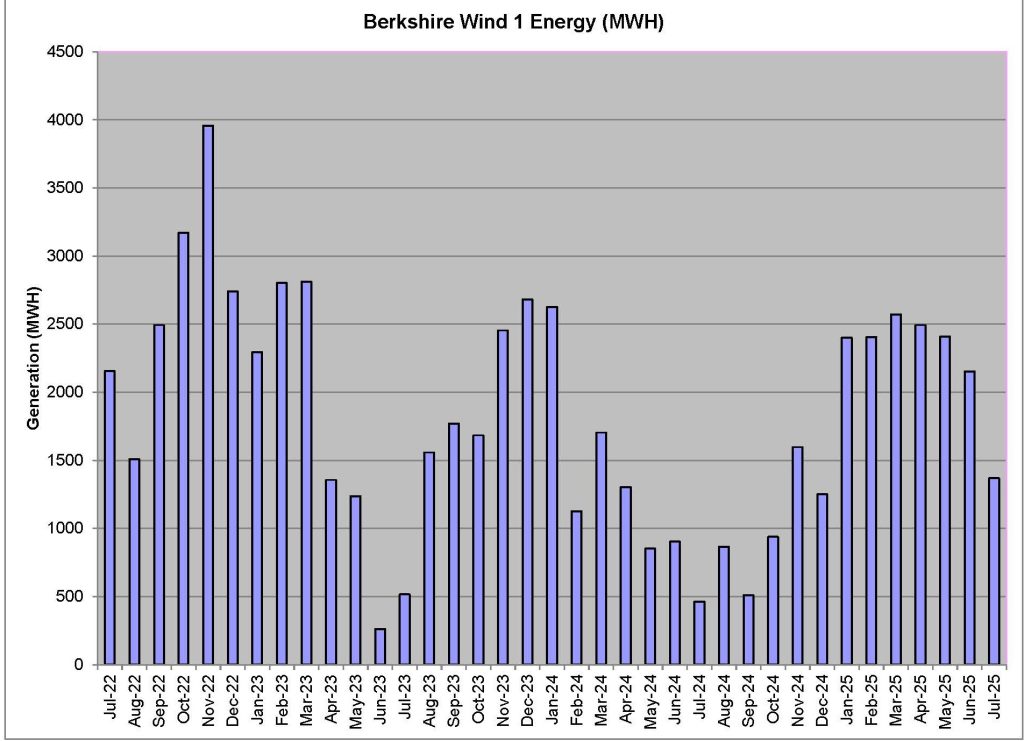

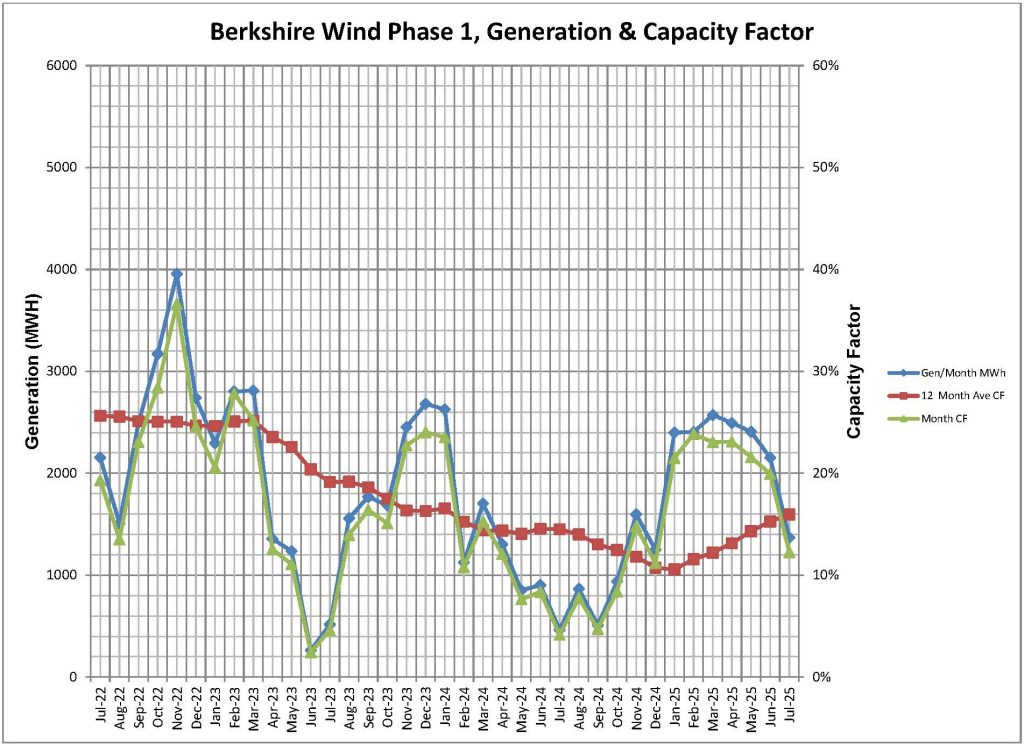

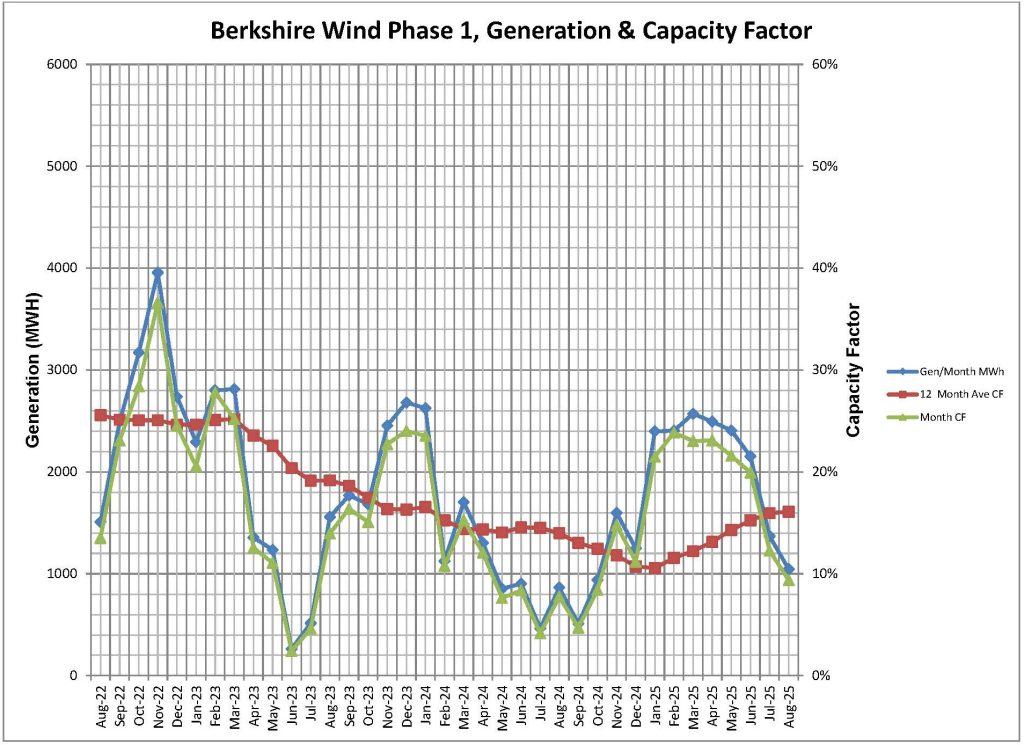

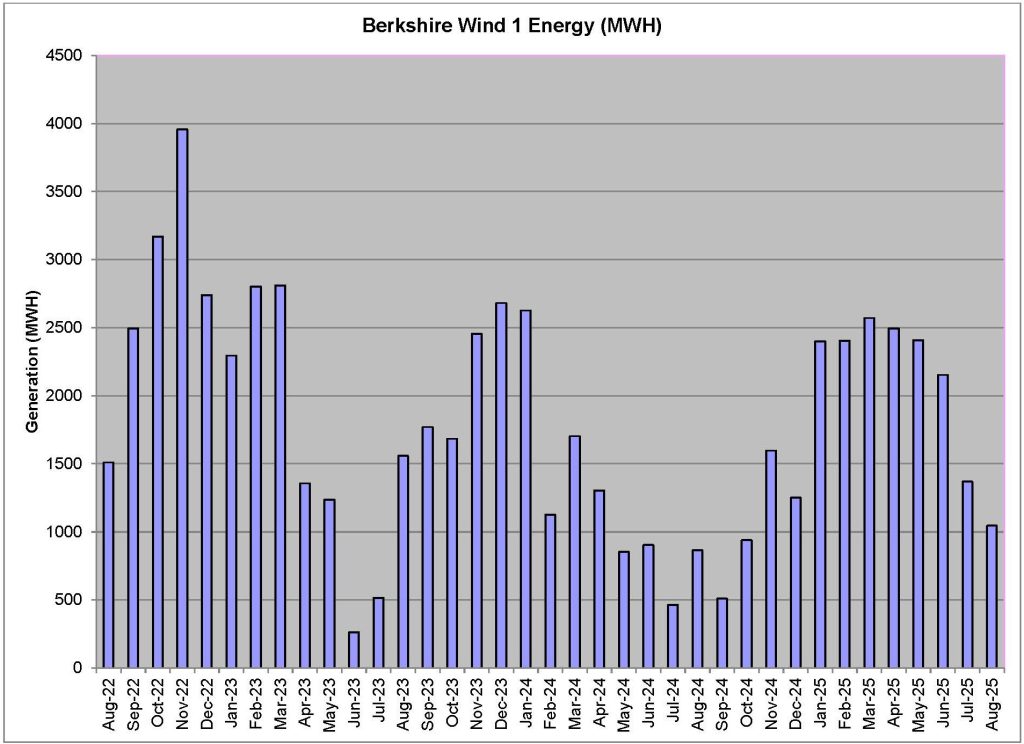

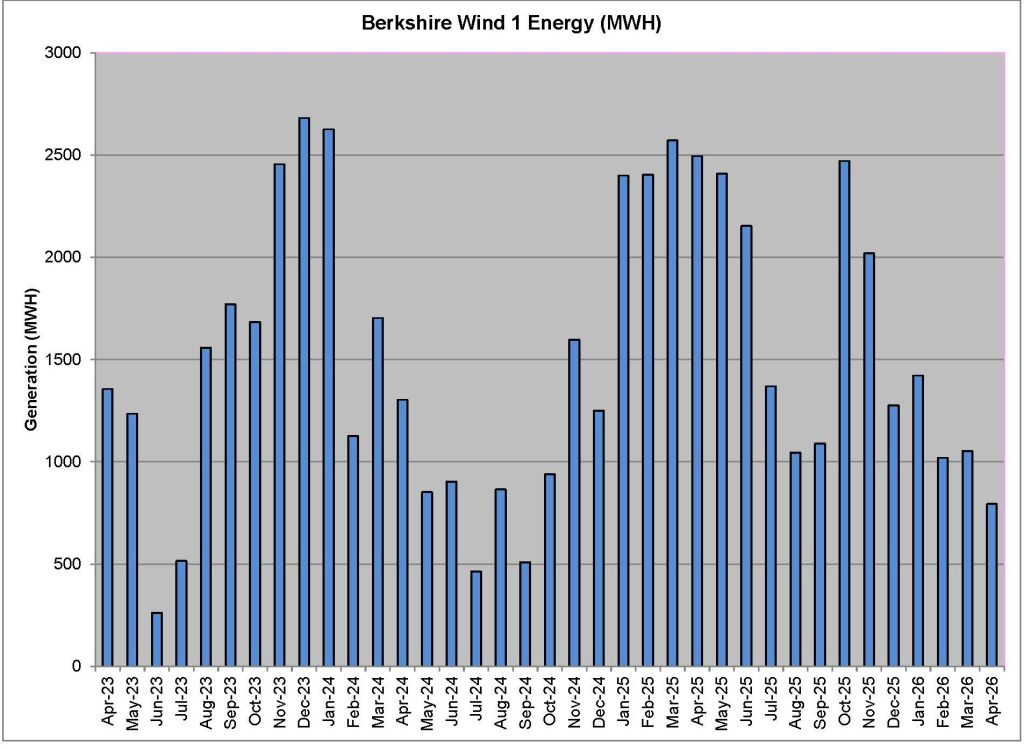

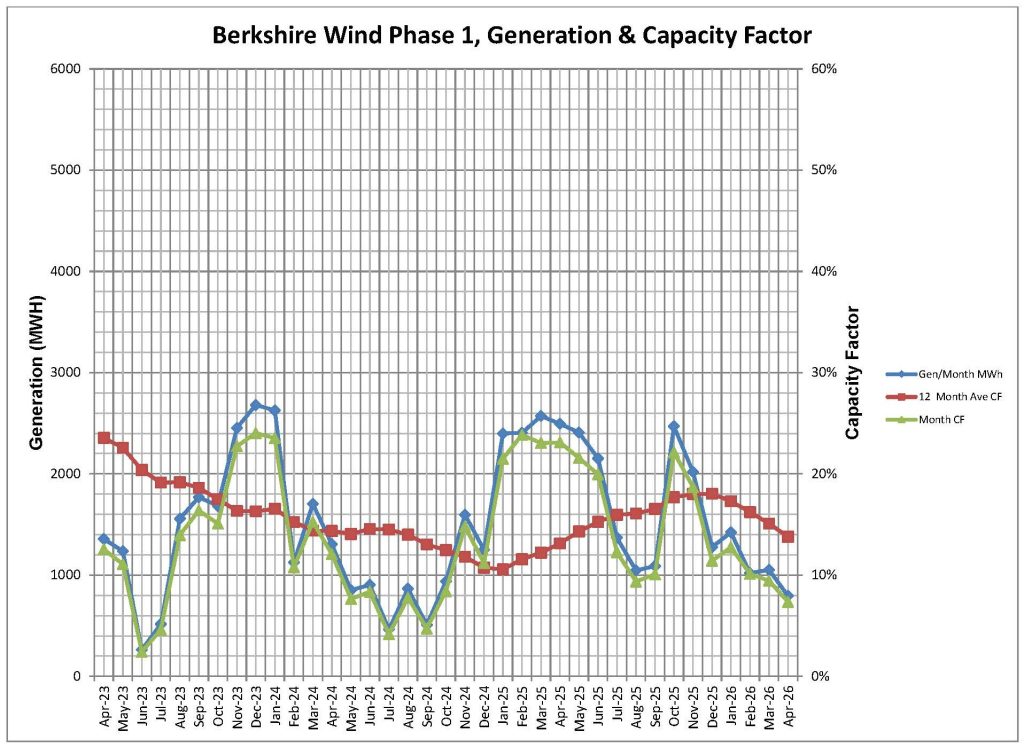

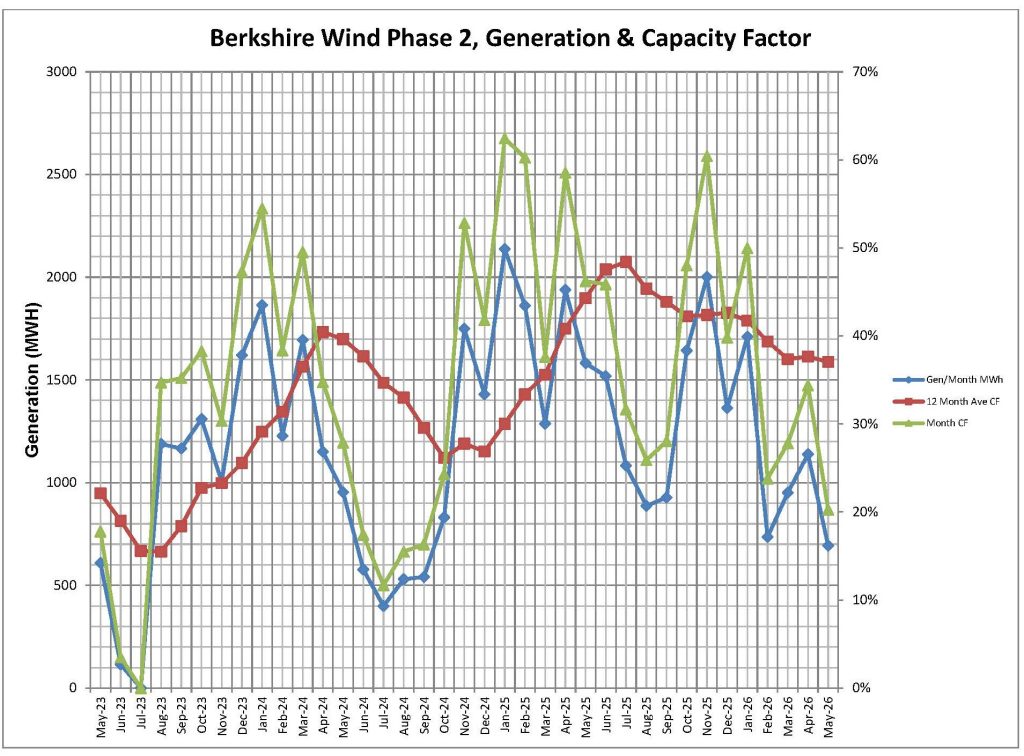

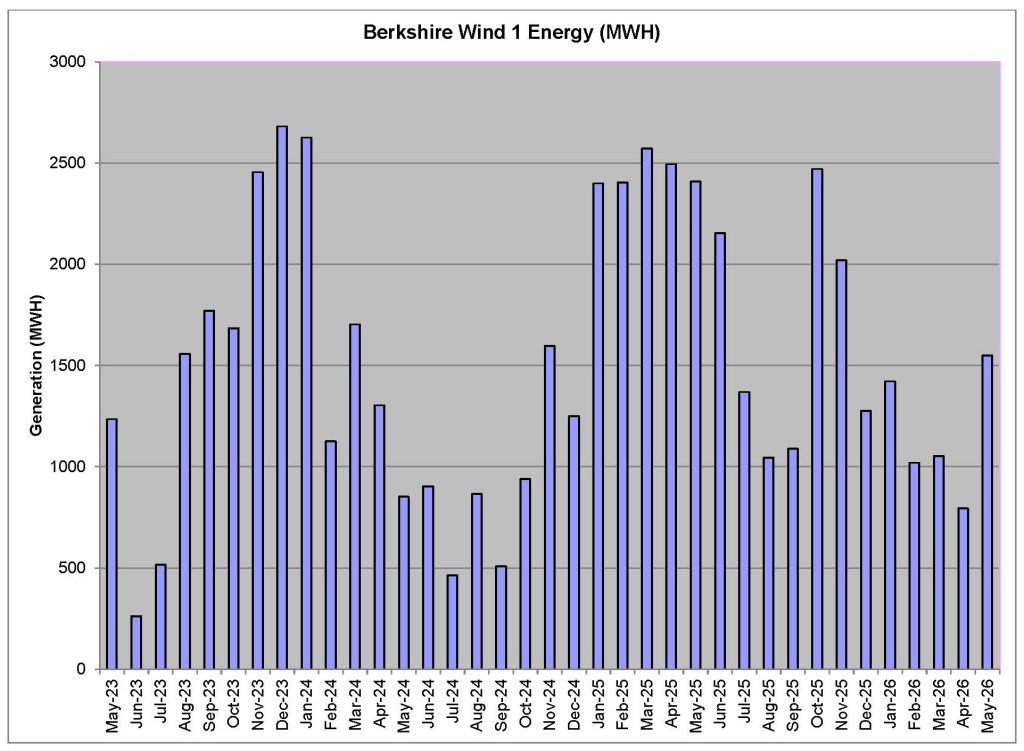

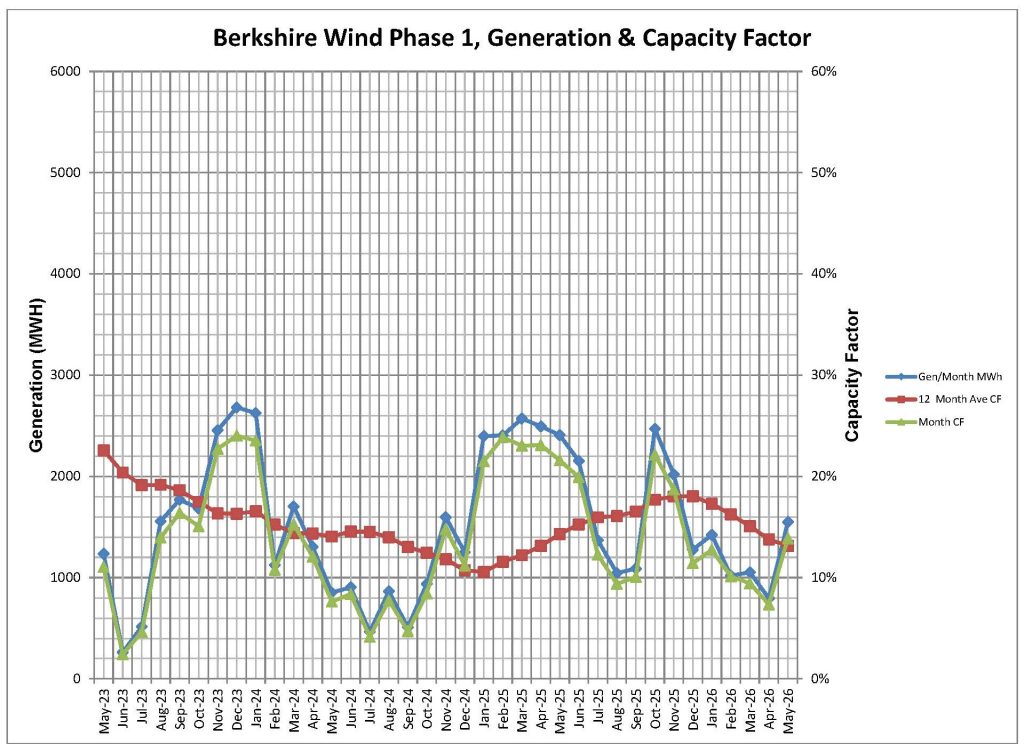

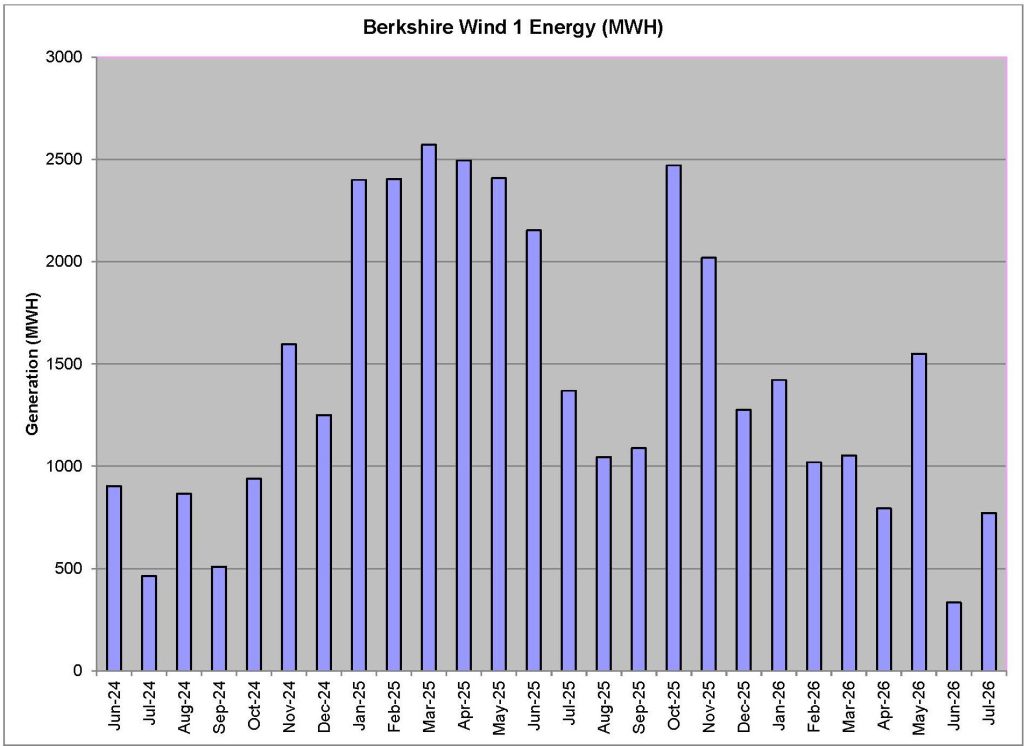

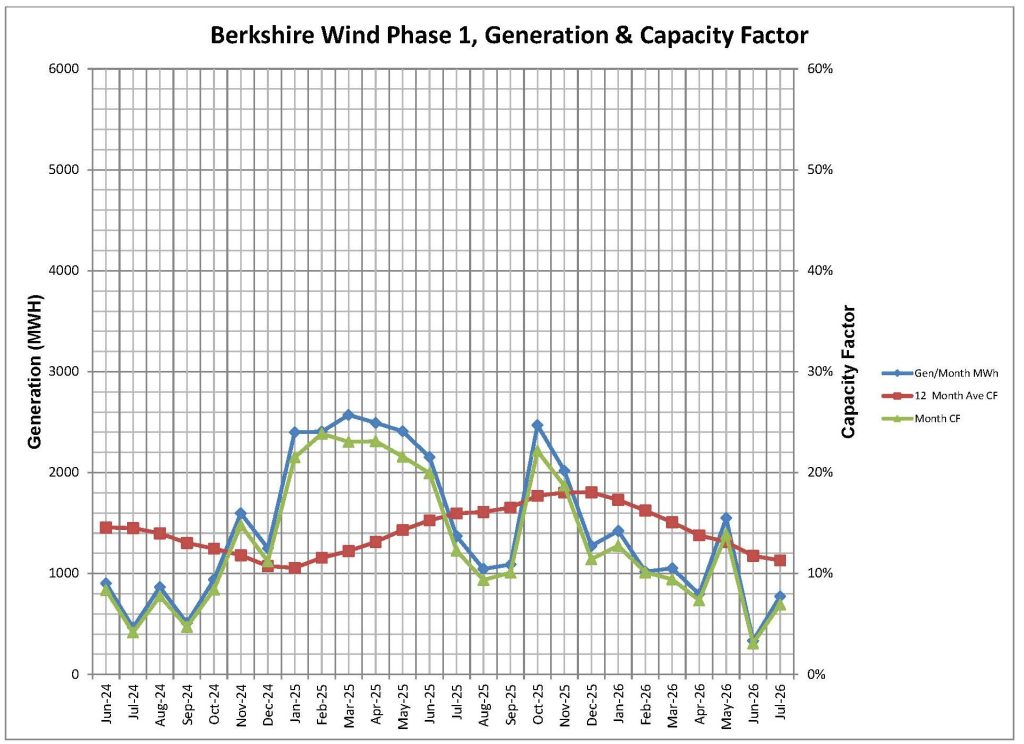

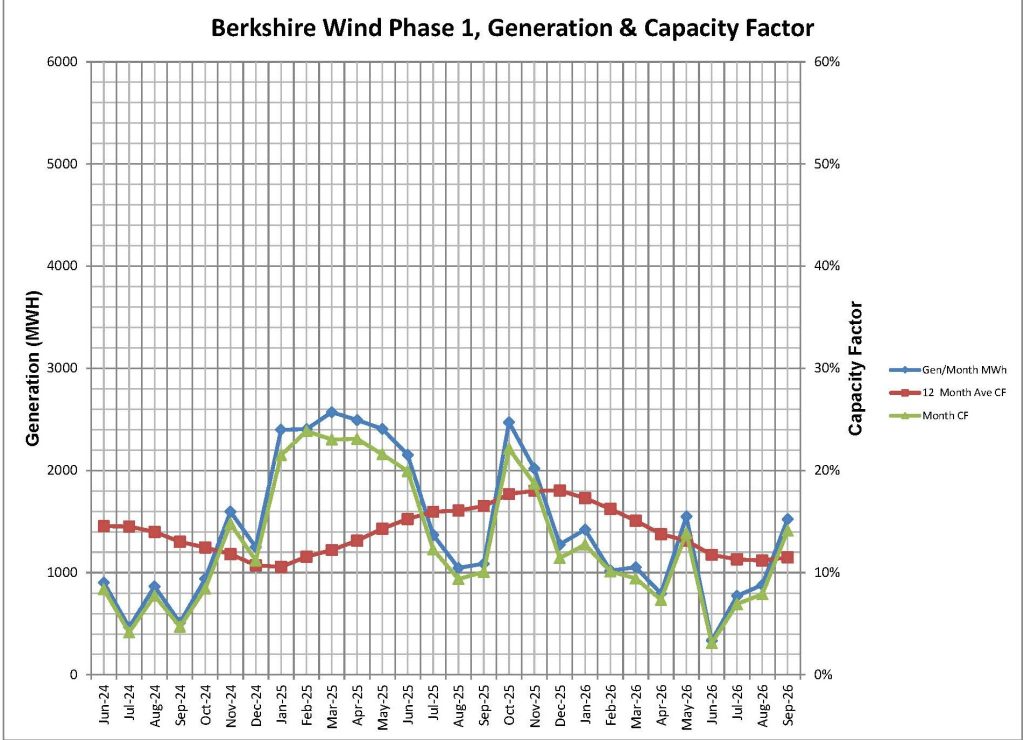

For the 2026 operating year, below is the monthly generation data and historical average monthly generation data for the project. As of September 2026, the Berkshire Wind Power Project completed 185 months of operation.

  • Average Capacity Factor for the month of September since COD: 20.80%
  • Capacity Factor since COD: 21.62%

Throughout the month of September, total production from Berkshire Wind Phase 1 was 1,523.6 MWh. This is higher than the historical average of 1,359.25 MWh. This increase in production was due to increased project availability.

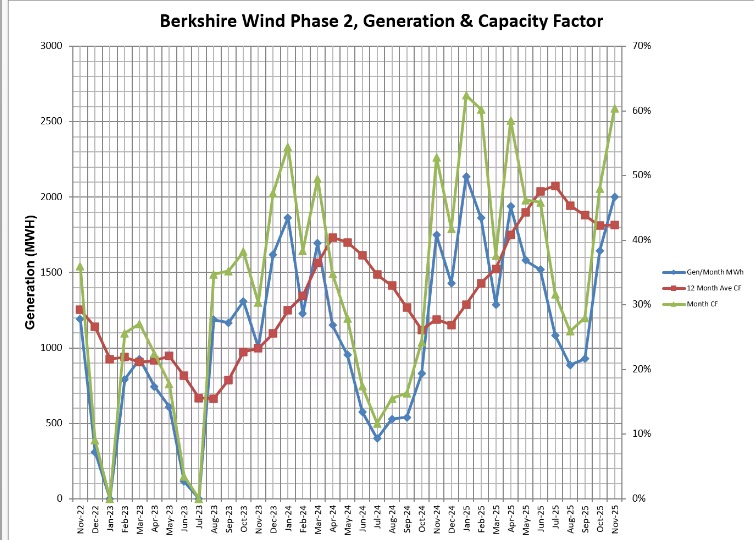

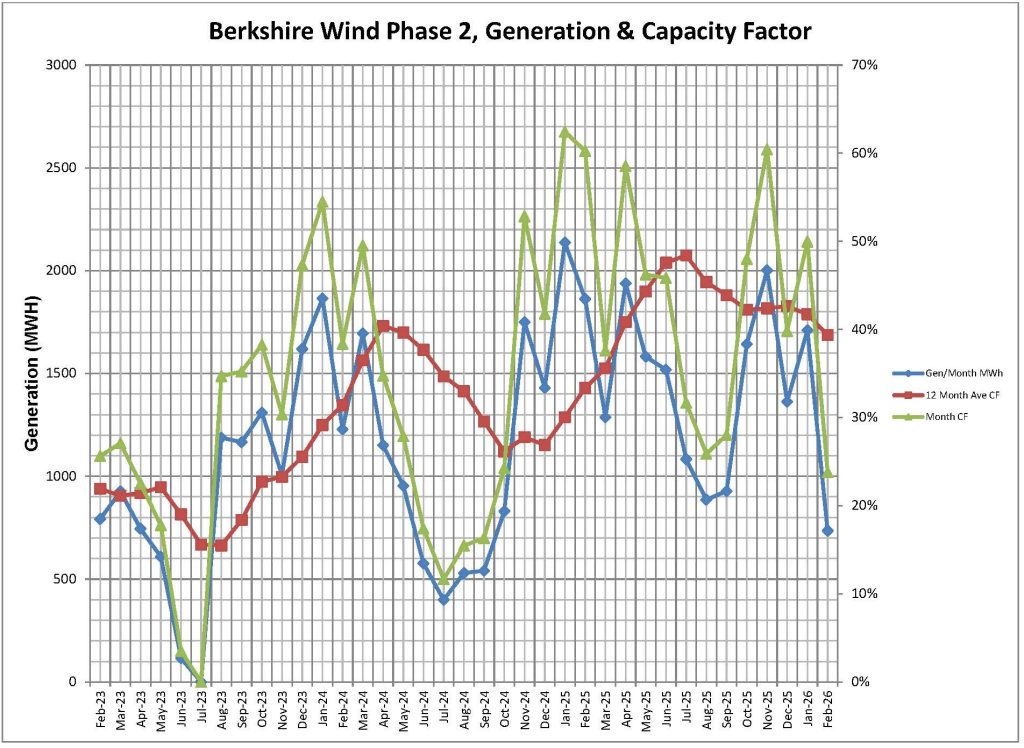

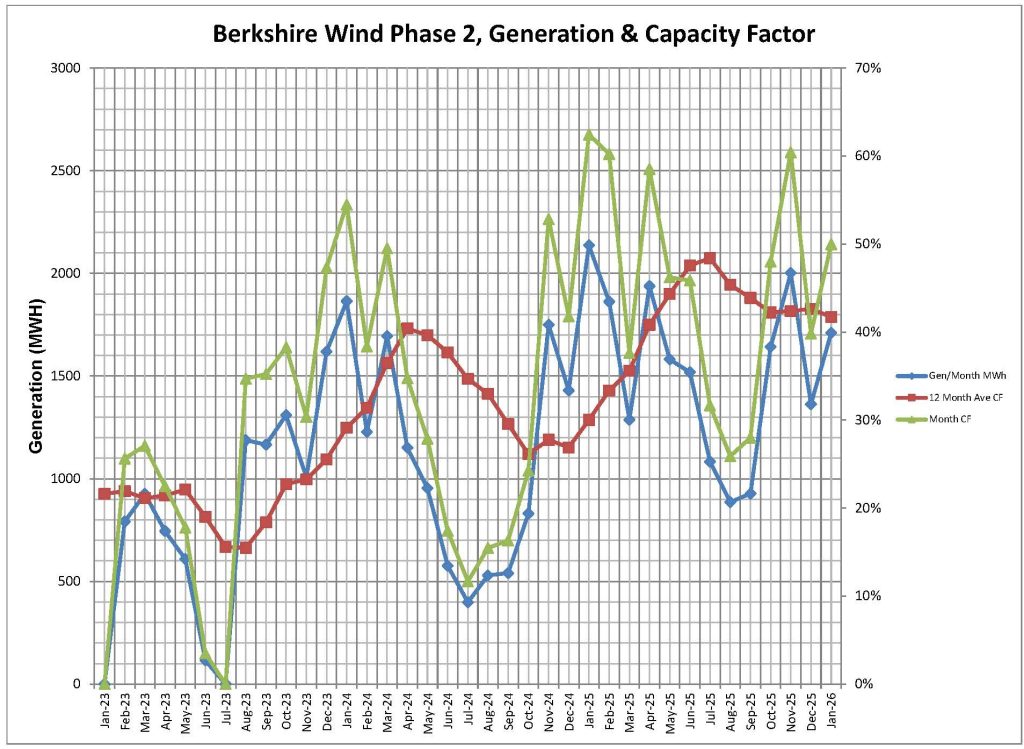

Berkshire Wind Phase II

The Unit Availability and Capacity Factors are as follows:

   September 2026      Year-to-Date
Availability Factor (AF)       77.59%           62.37%
Capacity Factor (CF)         29.51%           25.44%

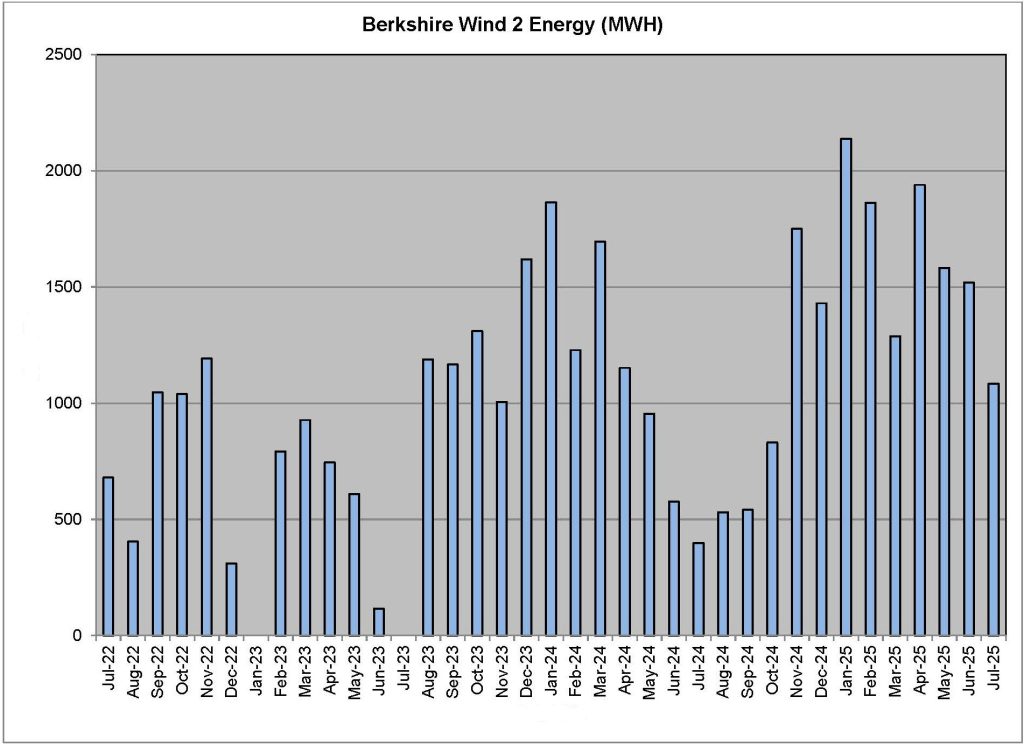

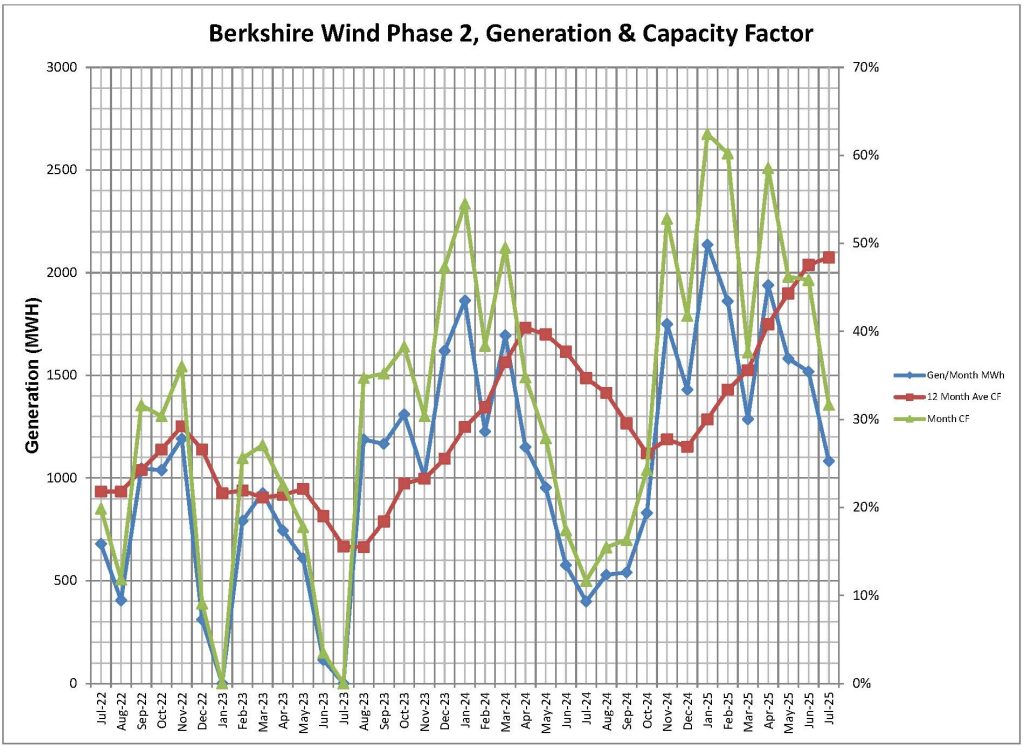

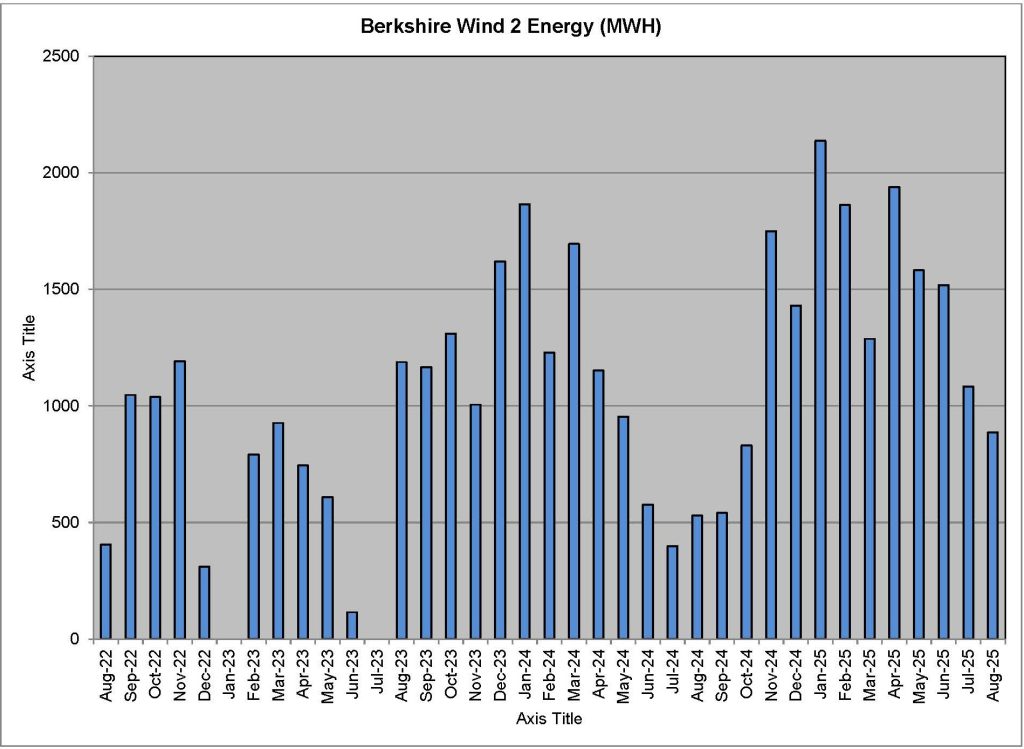

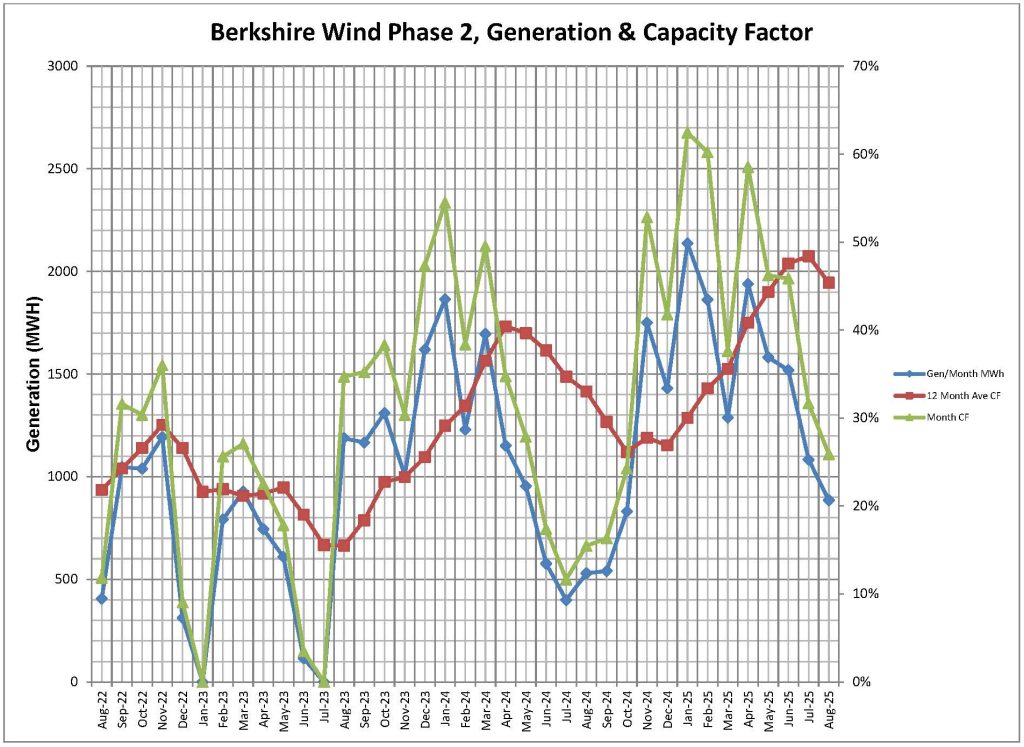

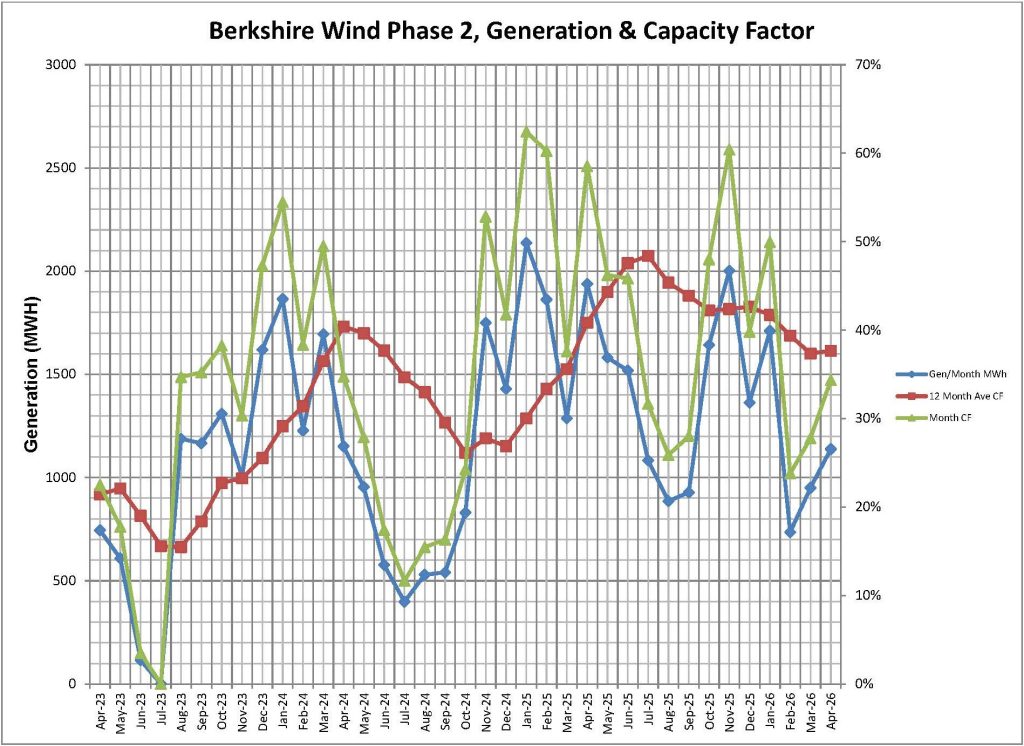

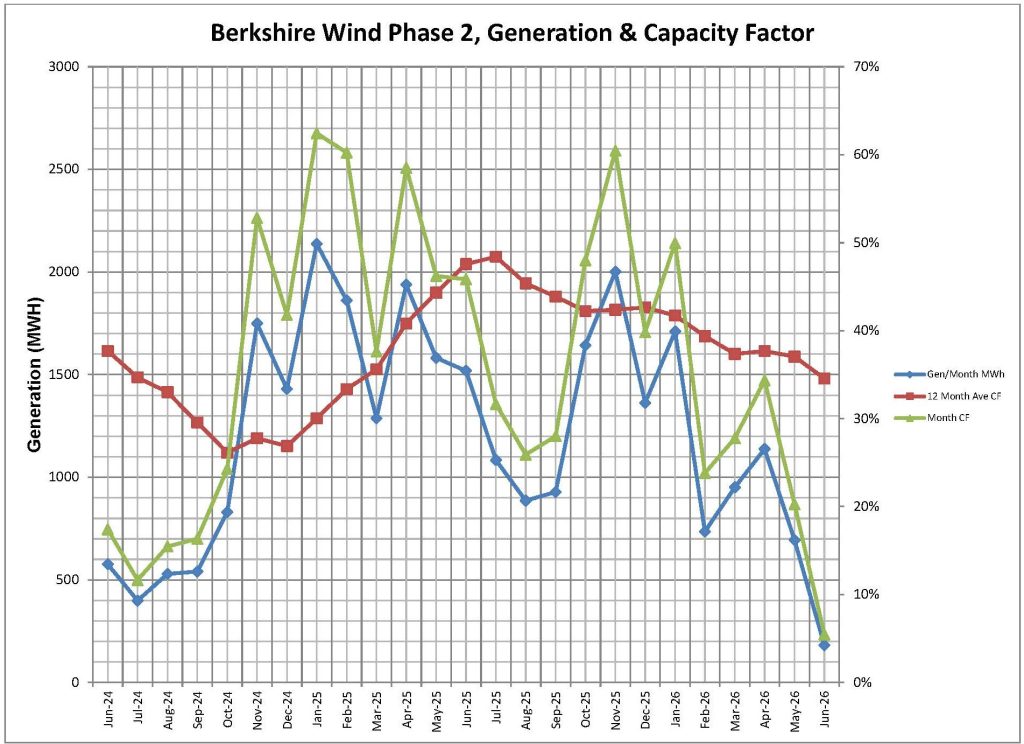

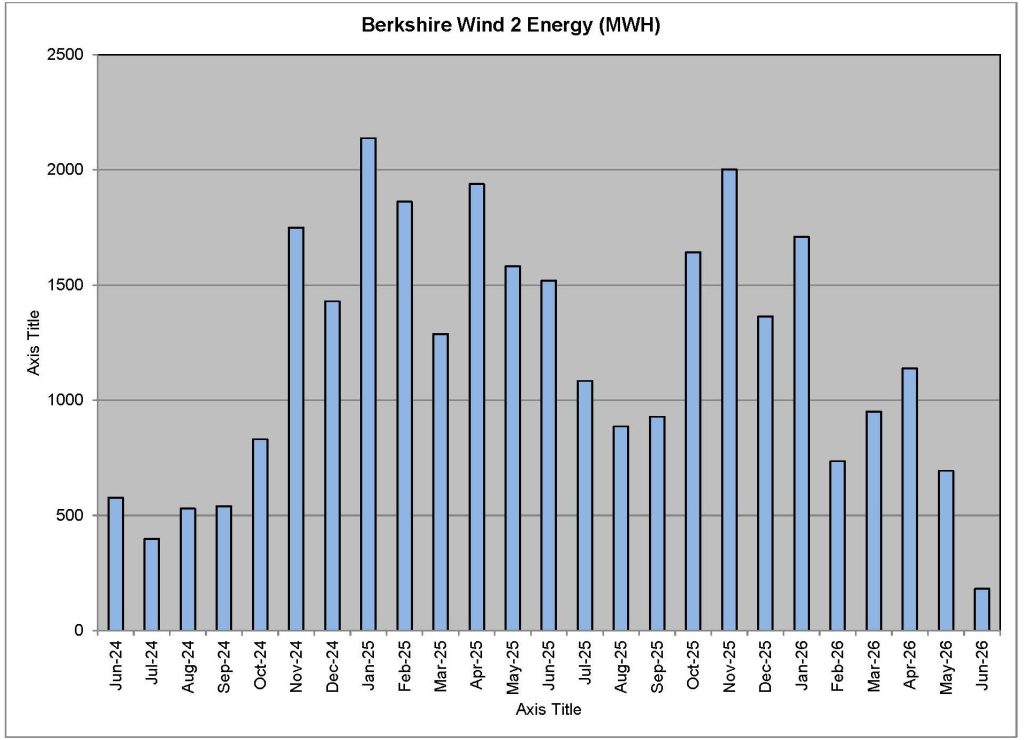

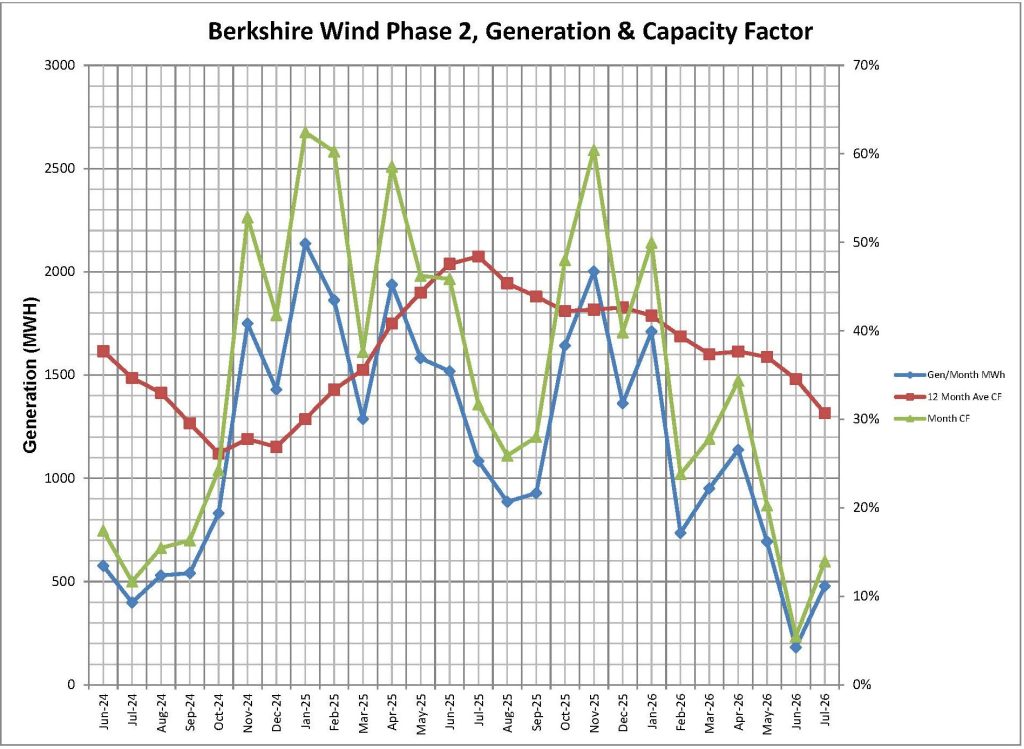

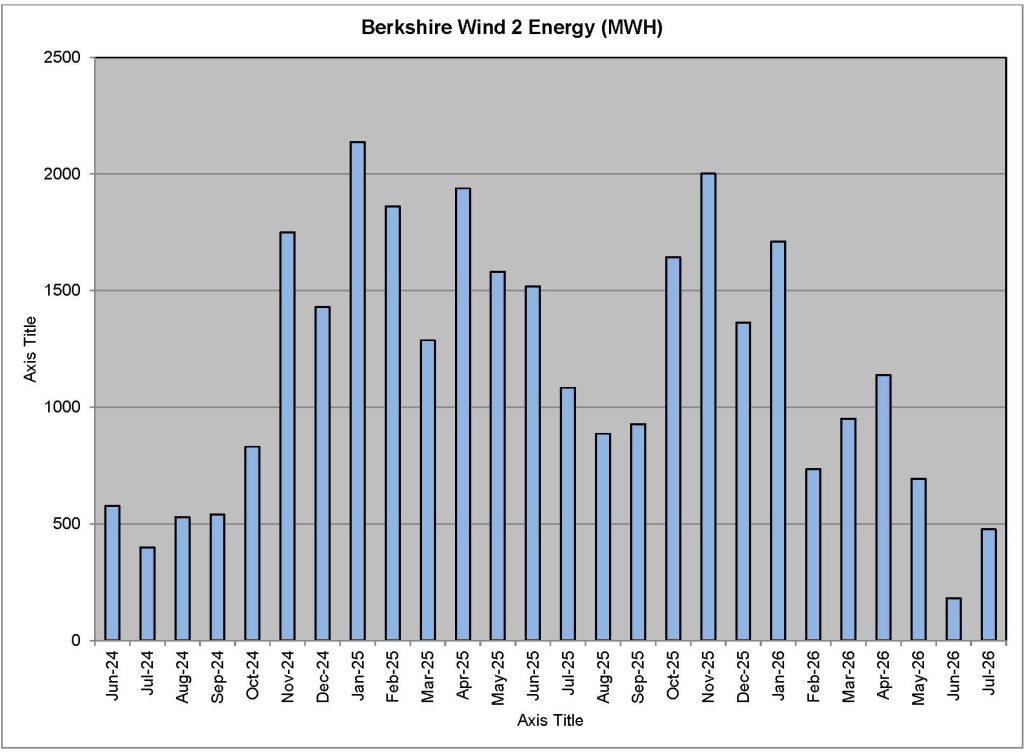

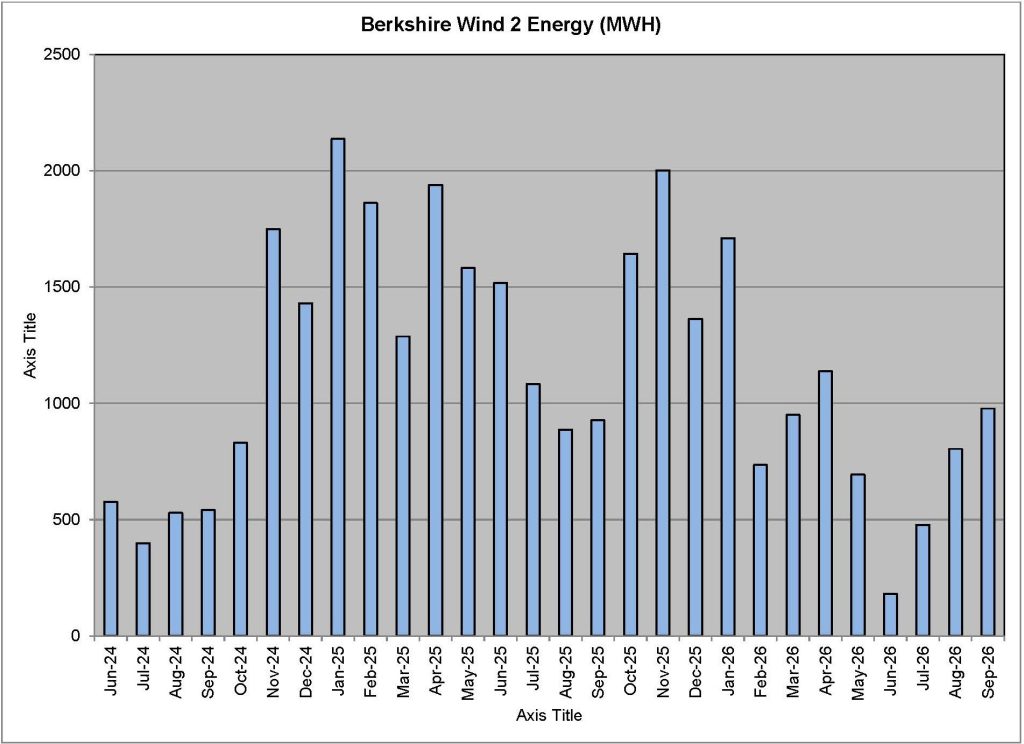

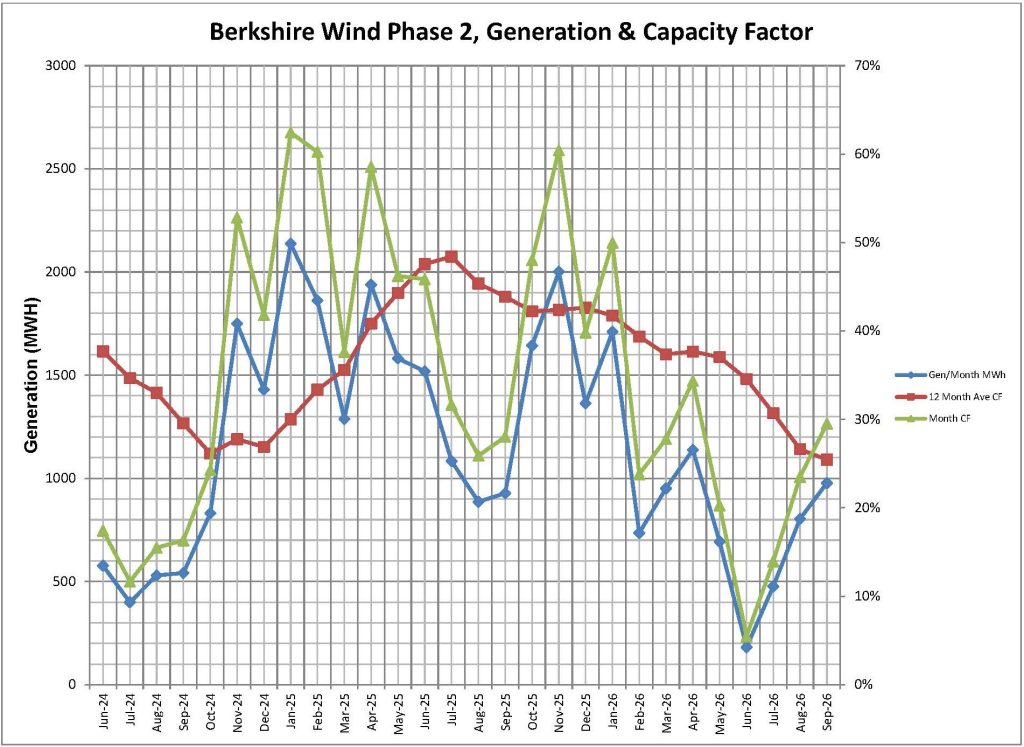

For 2026 operating year, below is the monthly generation data for the project. As of September 2026, the Berkshire Wind Phase 2 project completed 84 months of operation.

  • Average Capacity Factor for the Month of September since COD: 26.73%
  • Capacity Factor since COD: 31.30%

Throughout the month of September, total production from Berkshire Wind Phase 2 was 977 MWh. This is slightly higher than our historic average of 885.36 MWh. This increase in generation was due to increased project availability.
